Getting your software development cost estimation wrong isn't just a simple budget problem—it's a direct threat to your entire project. An inaccurate forecast can blow your budget, torpedo launch dates, and sour client relationships before you’ve even written a single line of code.
The Real Cost of Getting Estimates Wrong
Underestimating a software project is far more than a minor miscalculation. It kicks off a domino effect that can cripple teams and jeopardize the business. When the initial numbers are overly optimistic, the pressure cooker gets turned up to high.
Developers burn out trying to hit impossible deadlines, and quality assurance is often the first thing to get squeezed. The result? A buggy, unreliable product. This inevitably leads to a frustrating cycle of rework, which ironically balloons the final cost far beyond what a more realistic initial estimate would have been.
The fallout doesn't stop there. Credibility with stakeholders and investors takes a massive hit. Trust erodes when you keep missing timelines and have to go back, hat in hand, asking for more funding. That’s why getting the estimate right isn't about predicting the future with a crystal ball; it's about managing risk and building a realistic roadmap from the very beginning. It completely changes the conversation from "How cheap can we build this?" to "What will it truly take to build this right?"
From Guesswork to Strategic Planning
One of the biggest mistakes I see is treating estimation as a one-and-done guess. It's not. The best way to approach it is as an ongoing discovery process. This has been a known challenge for a long time; software cost estimation became a serious field of study way back in the 1950s. We’ve come a long way from simply counting lines of code to using sophisticated algorithmic models.
A modern, strategic approach means breaking the project down into smaller, more manageable pieces. For bigger initiatives, truly understanding the complete enterprise software development process is the only way to spot all the potential cost drivers. When you meticulously map out each phase, from discovery to deployment, you create a budget that's both transparent and defensible.
"A poor estimate is the root of a thousand project problems. It sets unrealistic expectations that haunt a project from kickoff to a potentially failed launch."
Ultimately, a solid estimate is your most important communication tool. It gets the development team, stakeholders, and clients all on the same page, with a shared understanding of the project's scope, complexity, and what it's going to take to get it done. Achieving that alignment is the first, and most critical, step toward a successful launch.
To get a clearer picture, let's break down the primary components that drive these costs.
Core Factors Driving Software Development Costs
Cost Factor | Description | Example Impact |
---|---|---|
Project Size & Complexity | The number of screens, features, business logic rules, and user roles. | A simple 5-screen app is far cheaper than a 50-screen enterprise platform with complex workflows. |
Tech Stack & Integrations | The programming languages, frameworks, and third-party APIs needed. | Using a niche, specialized technology might require expensive, hard-to-find developers. |
Team Composition | The number and seniority of developers, QAs, designers, and project managers. | A senior-heavy team costs more per hour but can deliver higher quality faster, potentially saving money long-term. |
UI/UX Design | The level of fidelity required, from basic wireframes to custom animations. | A highly polished, brand-centric design with custom graphics costs significantly more than a standard template. |
Post-Launch Support | Ongoing maintenance, bug fixes, server costs, and feature updates after release. | A critical B2B application requires a 24/7 support plan, adding a recurring operational cost. |
Each of these factors interacts with the others, which is why a detailed, holistic view is essential for creating an estimate you can actually count on.
Choosing the Right Estimation Model for Your Project
Picking the right model for your software development cost estimation is more than just a box-ticking exercise. It's a strategic call that shapes how you plan work, talk about progress, and manage expectations from day one. There’s no magic formula here; the best model is the one that fits your project's context, your team's rhythm, and how much you actually know upfront.
Think of these models as different lenses. Some give you a sharp, data-driven view, while others rely on the seasoned eye of experience. The real goal is to choose the lens that brings the work ahead into the clearest focus.
An Agile team building a new e-commerce app from the ground up, for example, is going to get a lot more mileage out of a flexible, iterative model. Meanwhile, a team migrating a clunky legacy system with crystal-clear parameters would probably be better off with a more structured, function-based approach.
Algorithmic vs. Heuristic Models
Estimation models pretty much fall into two camps. Algorithmic models are the math-heavy ones, using formulas based on historical data and project variables to spit out an effort and cost. The idea is to be objective by plugging your inputs into a time-tested equation.
On the flip side, heuristic models are all about experience. They’re built on expert judgment, educated guesses, and drawing parallels to similar jobs you've tackled before. It's less about formulas and more about leaning on your team's collective wisdom.
The debate over which is "better" is nothing new. Algorithmic models like COCOMO and Function Points have been under the microscope since the mid-1980s, and studies have shown their predictive power can be iffy unless you meticulously calibrate them with your own project data. Some of these models ask for things like "source lines of code," which is a nightmare to guess early on. If you want to dive into the research, you can learn more about these foundational software estimation models and their early empirical studies.
This all points to one crucial truth: no model is a silver bullet. Real success comes from picking the right tool for the job and then tweaking it to fit your team's reality.
When to Use Which Model
Let's ground this in some real-world situations to see how it all shakes out.
-
Story Points (Agile Estimation): This is the bread and butter for most Agile teams. Instead of talking in hours, the team assigns "points" to tasks based on a mix of effort, complexity, and uncertainty. It’s a perfect fit for projects where you know the requirements will shift and evolve, like when you're building a brand-new SaaS product. A simple UI tweak might be a "1," while a gnarly third-party API integration could easily be an "8."
-
Analogy-Based Estimation: This is a classic heuristic method. You find a similar project from your past and use its actual cost and timeline as a benchmark for the new one. It works beautifully when you have solid historical data and the new project is a genuine look-alike. For instance, if you built a nearly identical reporting dashboard for another client last year, that project is your perfect starting point.
-
Function Point Analysis (FPA): This is a more formal, algorithmic approach. You systematically quantify the business functionality the software delivers from the user's perspective—things like inputs, outputs, queries, and files. FPA is a solid choice for massive enterprise systems or government contracts where the scope is nailed down and needs to be measured in a way that’s totally independent of the tech stack.
Comparison of Top Estimation Methodologies
To make the choice a bit clearer, it helps to see these methods side-by-side. Each has its place, and understanding their strengths and weaknesses is key to avoiding a mismatch.
Methodology | Best For | Pros | Cons |
---|---|---|---|
Story Points (Agile) | Iterative projects with evolving requirements (e.g., SaaS, mobile apps). | Flexible, team-centric, focuses on relative effort, fosters collaboration. | Can be abstract for non-technical stakeholders, relies on team consistency. |
Analogy-Based | Projects that are very similar to previously completed work. | Quick, simple, and grounded in real historical data. | Highly dependent on finding a truly comparable past project; can be inaccurate otherwise. |
Function Point Analysis | Large-scale, waterfall projects with well-defined scope (e.g., enterprise systems). | Tech-agnostic, provides an objective measure of functionality, good for fixed-price contracts. | Complex, time-consuming to calculate, requires specialized training. |
3-Point Estimation | Tasks with high uncertainty where a single number feels like a wild guess. | Accounts for risk and uncertainty, provides a probable range, encourages realistic thinking. | Can be more time-consuming than single-point estimates; requires more input. |
Ultimately, the best approach is often a blend of techniques. You might start with a high-level analogy to give stakeholders a ballpark figure, then shift to Story Points for the detailed, sprint-by-sprint planning with the dev team.
A classic blunder is trying to shoehorn an Agile team into a rigid, top-down estimation model. All it does is create friction and kill the very flexibility that makes Agile work in the first place. Always match the model to the methodology, not the other way around.
The trick is to be intentional. Understand the pros and cons of each model, and pick the one that gives your project the clarity it needs, right where it is today.
Your Estimation Workflow From Scope to Sign-Off
So, how do you get from a great idea to a number you can actually count on? A reliable software development cost estimation isn't a magic trick; it’s the result of a clear, repeatable process. It’s built on a solid foundation of well-defined scope, realistic input from your team, and a healthy dose of respect for the unknown.
Let's walk through a workflow that will take you from a raw concept to a defensible estimate that stakeholders can get behind.
The single biggest point of failure in any estimate is a fuzzy scope. It's where things start to go wrong, not because of bad math, but because of ambiguity. Vague requests like "build a user-friendly dashboard" are practically an open invitation for scope creep down the line. Your job is to translate every single idea into a concrete, documented feature.
This is where a Work Breakdown Structure (WBS) becomes your best friend. A WBS is a simple but powerful tool for deconstructing the entire project into smaller, more manageable pieces. It forces you and the team to think through every component, from setting up the database to designing the confirmation email.
Creating a Detailed Work Breakdown Structure
Think of a WBS as more than just a glorified to-do list; it’s a hierarchical map of the project. You start with the big-ticket items—the "epics"—and then methodically break them down into smaller features, and then break those down again into specific, individual tasks.
Let's imagine you're adding two-factor authentication (2FA) to your SaaS product. A piece of your WBS might look something like this:
- Epic: Implement Two-Factor Authentication
- Feature: User Enrollment
- Task: Design UI for 2FA setup screen.
- Task: Develop front-end components.
- Task: Create API endpoint to enable 2FA for a user.
- Task: Integrate with an SMS gateway for code delivery.
- Feature: User Login Flow
- Task: Update login UI to include a code-entry field.
- Task: Build front-end logic for the verification step.
- Task: Create API endpoint to verify the 2FA code.
- Task: Implement session management for verified users.
- Feature: User Enrollment
Getting this granular does two crucial things. First, it makes it much harder for important details to slip through the cracks. Second, it makes the next part of the process—getting input from your team—incredibly more effective and accurate. It’s far easier for a developer to estimate the work for "create API endpoint to verify the 2FA code" than it is for the entire "build 2FA" epic.

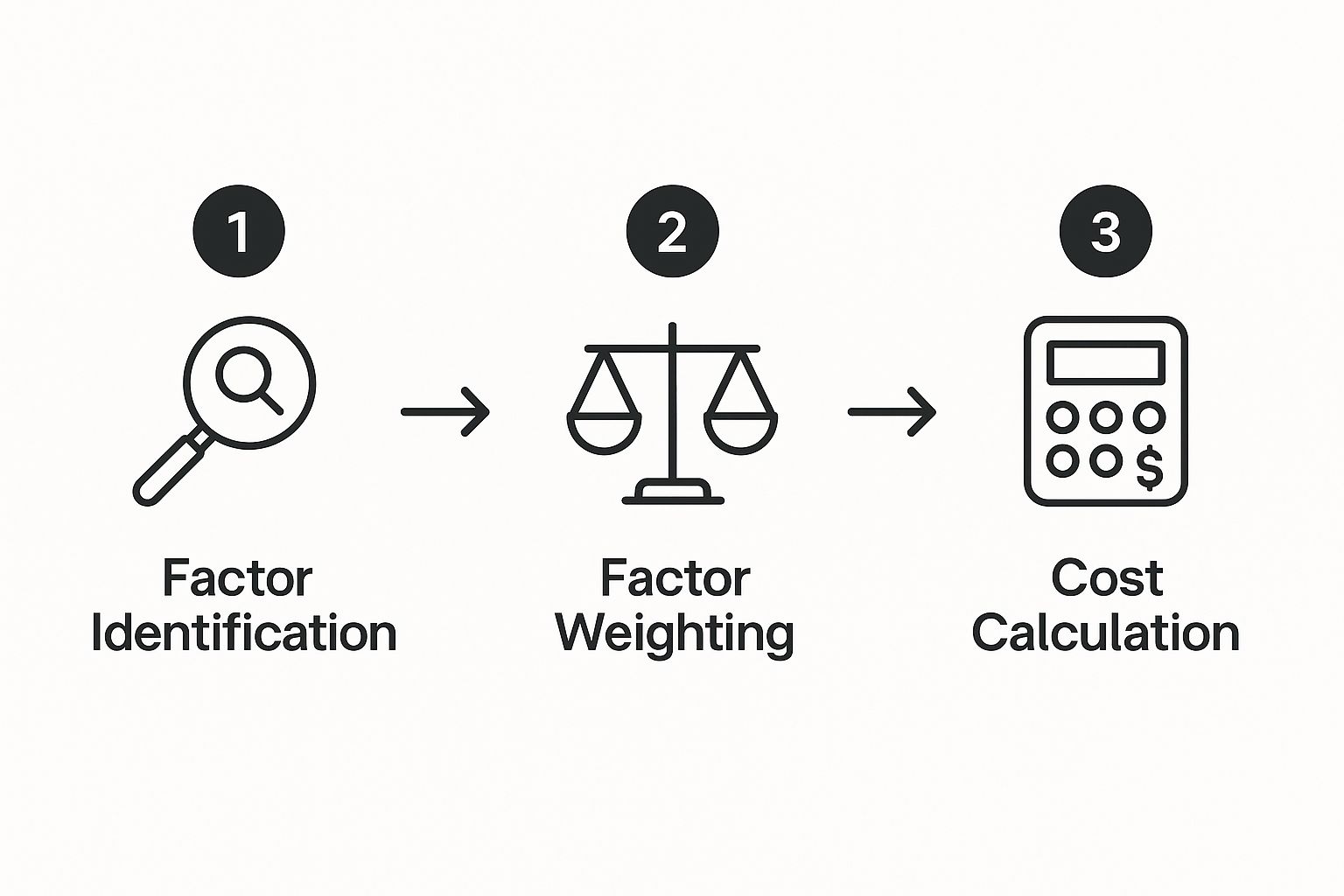

This simple infographic really captures the flow of turning all these factors into a final cost.
As you can see, the process starts with identifying each task (just like in the WBS), figuring out its complexity, and then running the numbers to get to a structured, logical estimate.
Gathering Inputs and Managing Expectations
With a solid WBS in hand, it's time to bring in the experts: the people who will actually be doing the work. The classic mistake is having a project manager create estimates in a vacuum. Your developers, designers, and QA engineers have the ground-level view and the most realistic understanding of the effort required.
Hand them the list of broken-down tasks and ask for their estimates. If you’re running an Agile shop, this is the perfect time for a planning poker session to assign story points. In a more traditional setup, you might ask for estimates in ideal hours. The method matters less than the principle: get direct input from the source.
This is also your chance to align with stakeholders. Walk them through the WBS. This kind of transparency helps them see the real complexity behind their requests and sets the stage for a realistic conversation about timelines and budget.
One of the most common pitfalls is presenting a single, overly optimistic number. Instead, always give stakeholders a range (using 3-point estimation, for example) that covers best-case, likely, and worst-case scenarios. This completely reframes the conversation around managing risk and making smart trade-offs, not just haggling over a single price.
Building in a Buffer for Risk
Let's be honest: no project ever goes exactly to plan. Unexpected technical debt, a key team member getting sick, or a sudden shift in business priorities—these things happen. A professional software development cost estimation has to account for this uncertainty.
But your buffer can't just be a number you pull out of thin air. A great way to calculate it is by creating a risk register right alongside your WBS. For your key tasks, identify potential risks and give each one a probability and impact score.
For instance:
- Risk: The third-party SMS gateway API has poor documentation.
- Probability: High.
- Impact: Medium (could add 10-20 hours of extra integration work).
When you start quantifying risks like this, your contingency buffer becomes a calculated part of the plan—typically somewhere between 15-20% of the total estimated effort. You can then confidently justify this to stakeholders. This isn't padding the budget; it's a professional acknowledgment of reality.
Once you combine the detailed task estimates with a smart risk buffer, you can finalize the total effort, apply your team's rates, and arrive at a final cost that's ready for sign-off.
How to Sidestep Common Estimation Pitfalls
Even with the best models and a solid process, a software development cost estimation can still go completely off the rails. I've learned from experience that estimation is as much about navigating human dynamics and unspoken assumptions as it is about crunching numbers.
Knowing where the traps are is the first step toward building an estimate that can actually withstand real-world pressure.
One of the most common mistakes I see is just being too optimistic. We all want to believe a project will run like a well-oiled machine, but ignoring potential roadblocks is a surefire recipe for disaster. This "optimism bias" leads teams to underestimate complexity and completely gloss over the time needed for things like code reviews, rigorous testing, and deployment.
Another classic pitfall is simply caving to pressure from stakeholders. A client or an executive wants to see a lower number, and it’s incredibly tempting to shave the estimate to make them happy. This is a short-term win that almost always leads to long-term pain. You're setting the team up for burnout and the project up for failure when reality inevitably comes knocking.
Overlooking Non-Functional Requirements
A massive blind spot for many teams is forgetting to budget for non-functional requirements. Think of these as the "how well" aspects of the software, not just the "what it does" features. They are often invisible to the end-user but are absolutely critical to a successful, professional product.
Failing to account for them can dramatically inflate your final costs. Imagine launching an app that works perfectly for ten users but completely crashes when a thousand people try to log on. That’s a failure of scalability, and it stems from a failure to plan.
Here are a few critical non-functional requirements you absolutely must account for:
- Scalability: How will the system handle growth in users and data? This directly impacts server architecture and database design choices.
- Security: What measures are needed to protect user data and prevent breaches? This isn't just one task; it could involve penetration testing, encryption, and secure coding practices throughout development.
- Performance: How fast does the application need to feel? Hitting specific load time targets might require significant performance tuning and optimization work.
- Maintainability: Is the code well-structured and properly documented? Writing clean code takes more time upfront but drastically reduces the cost of future updates and bug fixes.
Each of these adds real hours—sometimes hundreds of them—to the project timeline. Forgetting them means your estimate is fundamentally flawed from the very beginning.
The Danger of a Single Number
If there's one thing to avoid, it's presenting your final estimate as a single, concrete number. A single figure implies a level of certainty that simply doesn't exist in software development. It immediately becomes a fixed target in the stakeholders' minds, leaving zero room for error or unforeseen challenges.
This is where a three-point estimation technique is an absolute game-changer. Instead of giving one number, you provide a calculated range:
- Optimistic (O): The best-case scenario, if every star aligns and nothing goes wrong.
- Most Likely (M): Your most realistic guess, based on your team's experience with similar work.
- Pessimistic (P): The worst-case scenario, where significant, plausible roadblocks appear.
By presenting a range, you completely reframe the conversation. It shifts from "Why does it cost so much?" to a more collaborative "What can we do to stay closer to the optimistic end of this range?" It turns the estimate into a risk management discussion, not a price negotiation.
This approach transparently acknowledges the inherent uncertainty and helps stakeholders understand the trade-offs between scope, timeline, and budget.
Mismanaging Scope Creep and Inaccurate Data
Budget overruns are a constant headache in our industry. For instance, recent analyses show that in 2023, around 47% of Enterprise Resource Planning (ERP) projects went over budget. The primary culprits? Uncontrolled scope creep and faulty initial estimates.
This is why a bottom-up estimation method is so valuable. You start with a clearly defined scope, break it down into the smallest possible tasks, and analyze them using historical data. This granular approach is your best defense against surprises.
It also highlights the absolute need for vigilant scope management. Any new feature request, no matter how small it seems, must be formally evaluated for its impact on the timeline and budget. A simple change request process is your best friend here.
Finally, a surprisingly common pitfall is neglecting quality assurance. When the pressure is on, testing is often the first thing to get squeezed. This is a critical error. A thorough process of software quality assurance isn't an expense; it's an investment that prevents costly, reputation-damaging bugs from ever reaching your users. Skimping on QA will always, always come back to haunt you.
Tools and Templates to Streamline Your Estimates
This screenshot of a Jira backlog is a perfect example of modern estimation in action. This isn't just a to-do list; it's a dynamic hub where teams can organize, prioritize, and assign story points to tasks, making progress visible and tangible.
Even the most sophisticated software development cost estimation methods fall flat without the right tools. Trying to track every variable on a notepad or in a scattered collection of documents is just asking for trouble. To move from theory to a reliable estimate, you need a system, whether that's a simple spreadsheet or a full-blown project management platform.
There's no single "best" tool, though. The right choice really comes down to your team's size, budget, and how you like to work. A small, scrappy team might get everything they need from a well-organized spreadsheet, while a larger company juggling multiple projects will almost certainly need something more powerful.
Project Management Software with Built-In Estimation
Today's project management platforms are built for this. Tools like Jira, Asana, and Trello have become the gold standard because they don’t just help you plan—they bake estimation right into the workflow.
For any team working in Agile, these tools are game-changers. You can create your product backlog, break down large epics into smaller user stories, and assign story points all in one place. The real magic, however, is in the reporting. They can automatically generate burndown charts and calculate your team's velocity, giving you hard data on your actual capacity. This makes your estimates for future sprints progressively more accurate.
If you're looking to sharpen your team’s process, our guide on https://www.42coffeecups.com/blog/agile-development-best-practices offers some really practical insights.
The biggest win from using an integrated tool like Jira is that it creates a single source of truth. Your estimate is no longer a static number buried in a proposal document; it's a living, breathing part of the project that adapts with every sprint.
This constant connection between the estimate and the actual work is what keeps it relevant. It prevents the estimate from becoming an abstract number that everyone forgets about the day after kickoff.
Building a Simple Estimation Template
You don't need to pay for a subscription to start improving your estimates right now. A simple spreadsheet can be an incredibly powerful tool, as long as it's structured logically. This DIY approach has the added benefit of forcing you to think through every component of the project from the ground up.
Here’s a straightforward template you can build yourself in Google Sheets or Excel:
- Work Breakdown Structure (WBS) Tab: This is your master list of every single task and feature, broken down into the smallest possible pieces. Create columns for your three-point estimates: optimistic, most likely, and pessimistic hours for each item.
- Risk Register Tab: On a separate sheet, list every potential risk you can think of. For each one, add columns for its Probability (Low/Medium/High) and its Impact (measured in hours or cost). This is how you build a data-backed contingency buffer.
- Cost Calculation Tab: This is your summary sheet. It pulls everything together by summing the task estimates, applying your team's blended hourly rate, and then adding your calculated risk buffer to give you a final estimated cost range.
This simple template gives you a transparent and defensible foundation for your estimate. It proves you’ve considered the key variables—scope, uncertainty, and risk—and gives you a solid starting point for any conversation with stakeholders.
Answering Your Toughest Software Estimation Questions
After digging into models, workflows, and common pitfalls, you probably still have a few questions rolling around in your head. That's normal. The world of software development cost estimation is full of nuance, and real projects rarely follow a textbook script.
This is where we tackle those tricky "what if" scenarios that pop up when you're in the trenches. Let's get into some of the most common and challenging questions I've seen project managers and stakeholders face over the years. My goal here is to give you clear, practical answers you can use when things get complicated.
How Do You Estimate a Project with High Uncertainty?
This is the classic dilemma, isn't it? You're working on something innovative, maybe an MVP, and the final scope is still a bit fuzzy. Trying to slap a single, fixed-cost number on that isn't just difficult—it's a recipe for disaster. You have to change your approach entirely.
Instead of a single bid, break the project into smaller, more digestible phases.
-
Kick off with a Paid Discovery Phase: Propose a small, fixed-cost engagement focused purely on research, prototyping, and nailing down the core requirements. The deliverable isn't working software; it's a crystal-clear project plan and a high-fidelity prototype. This simple step de-risks the entire project for everyone involved.
-
Embrace Range Estimates: For the actual development work, lean heavily on the three-point estimation method. Give them an optimistic, a realistic, and a pessimistic number. This immediately communicates the level of uncertainty and shifts the conversation from "what's the cost?" to "how do we manage risk?"
-
Work in Time-and-Materials Sprints: Suggest an initial block of development—say, the first two to four sprints—on a time-and-materials basis. This lets the team build real momentum and, more importantly, gather hard data on their velocity. After that initial push, you'll have a much more accurate baseline for estimating the rest of the project.
This phased strategy turns uncertainty from a project-killer into just another manageable part of the process.
What’s the Best Way to Communicate a Budget Overrun?
Ugh. Nobody wants to have this conversation. But handling it professionally and proactively can make all the difference. The absolute worst thing you can do is hide and hope it goes away. It won't. The key is early, transparent, and data-driven communication.
The moment you see a potential overrun on the horizon, book a meeting. Don't just walk into the room with a problem; come armed with a story and, most importantly, solutions.
Here’s what your conversation should cover:
- The "Why": Get straight to the point and explain the root cause. Was it an unexpected technical hurdle we couldn't have foreseen? A third-party API that was far more complex than its documentation suggested? Or maybe a series of small, client-approved changes that simply added up over time?
- The Impact: Present the new forecast, showing the updated timeline and budget. Back it up with real data from your project management tools. Show them the numbers.
- The Options: This is the most critical part. Give them clear choices. Frame it like this: "We can proceed with the new budget to get everything done, or we can defer features X and Y to a later phase to stay within the original budget. Here are the pros and cons of each path."
By framing the conversation around collaborative problem-solving, you give stakeholders control. It transforms a piece of bad news into a strategic discussion about what truly matters for the project's success.
Should We Include Maintenance Costs in the Initial Estimate?
Absolutely, but you have to present it separately. If you lump ongoing maintenance into the initial development budget, your quote can look bloated and scare clients away, especially when they're comparing you to competitors.
A professional, transparent estimate should break these costs down very clearly.
Cost Category | Description | Typical Budget Allocation |
---|---|---|
Initial Development | The one-time cost to design, build, test, and deploy the software. | This is the core project budget. |
Ongoing Maintenance | A recurring monthly or annual cost for hosting, monitoring, bug fixes, and minor updates. | Typically 15-20% of the initial development cost, per year. |
Presenting your numbers this way does two things. First, it’s honest. Second, it helps the client understand the Total Cost of Ownership (TCO), not just the upfront build price. It proves you're thinking about the long-term health of their product, which builds trust and positions you as a strategic partner, not just a vendor. This is a non-negotiable part of any comprehensive software development cost estimation.
At 42 Coffee Cups, we believe a great estimate is the foundation of a successful partnership. We combine deep technical expertise with transparent processes to deliver predictable, high-value results for your Next.js and Python/Django projects. Find out how we can help you build your next application on time and on budget.
